Geocell Reinforcement Test for Aeolian Sand Subgrade in Desert Highway

The S21 Altay-Urumqi Highway Construction Project, Xinjiang’s first desert highway, runs north-south through the Gurbantünggüt Desert, spanning 342.538 km. Designed for a speed of 120 km/h, the route uses a dual four-lane standard from Altay Beitun to Wujiaqu and a dual six-lane standard from Wujiaqu to Urumqi. Upon completion, it will open a direct commercial corridor between northern Xinjiang and Urumqi, reducing regional travel distances, improving transportation conditions, and cutting 260 km from the Urumqi-Altay route by eliminating detours.

As China’s largest fixed and semi-fixed desert, the Gurbantünggüt features sand dunes (10–50 meters high) with a south-high/north-low terrain. Given the region’s harsh environment, construction challenges, and the proven scientific merits of geocell-reinforced aeolian sand (e.g., convenient material sourcing, superior mechanical properties), on-site tests were conducted for the S21 project. The goal: validate geocell-reinforced aeolian sand for upper roadbed filling to achieve local material use, enhance subgrade stability, reduce costs, and enable eco-friendly rapid construction.

 Test Section Details

The geocell-reinforced aeolian sand subgrade test section is located in Contract Segment 4 of the S21 Altay-Urumqi Highway Phase I project, spanning K233+660 to K233+840. It uses integral welded geocells (independently developed and produced by Lanzhou Deke Engineering Materials Co., Ltd.) and a 19-meter ultra-wide pre-tensioned laying process. Key objectives include:

– Analyzing dynamic stress attenuation before/after geocell reinforcement

– Mapping stress-strain distribution in geocell-reinforced subgrades

– Validating theoretical models against real-world performance

– Providing engineering evidence for large-scale pre-tensioned laying technology deployment

 Geocell Product Specifications

– Type: Welded integral

– Height: 10 cm

– Mesh Size (expanded): 40 cm × 40 cm

– Single Unit Size (expanded): 4.25 m × 18.95 m

– Mechanical Indicators:

  – Tensile strength of geocell strips (N/cm)

  – Elongation at break (%)

  – Node strength (N/cm)

  – Weld peel force of U-shaped steel nails (N)

 Construction Process

1. Subgrade Preparation:

   – Excavate dunes and fill depressions in this semi-embankment/semi-cut section

   – Use bulldozers and rollers for dry compaction to meet density requirements

   – Verify subgrade elevation with RTK surveying

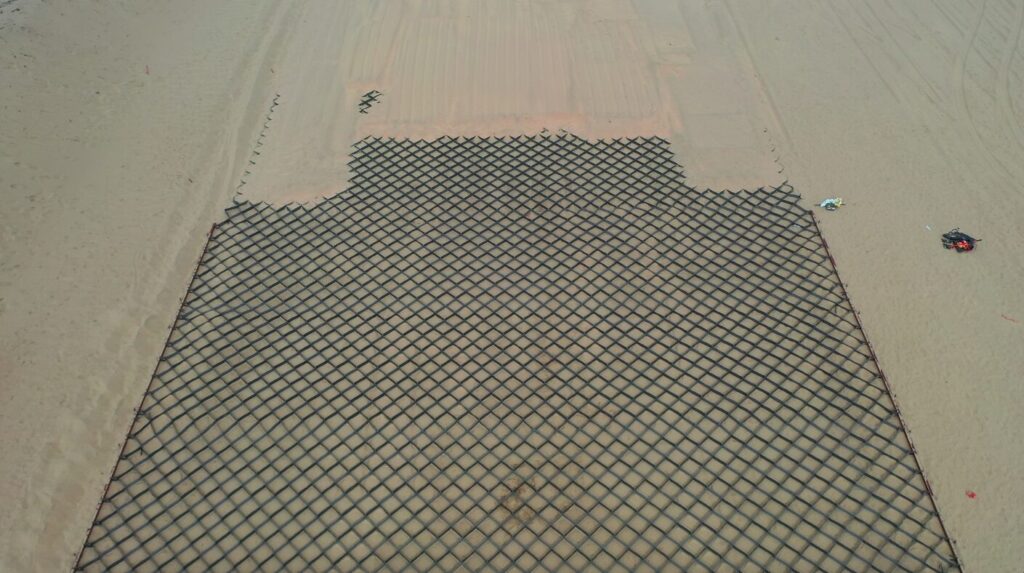

2. Geocell Laying:

   – Test Section: Full Installation (west half of K233+660–K233+840, 180m length); east half as control (no geocells)

   – Monitoring Section: K233+750, with sensors (dynamic soil pressure cells, accelerometers, settlement gauges, etc.) buried at different depths to monitor:

     – Geocell tensile strain

     – Dynamic stress at varying roadbed depths

     – Vertical settlement and horizontal soil deformation

     – Temperature/humidity changes

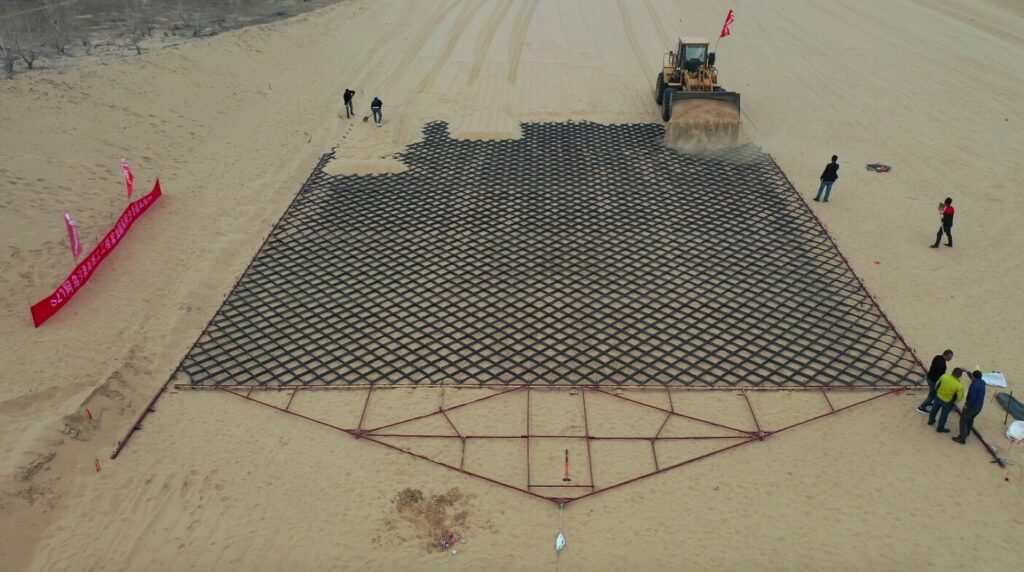

3. Pre-Tensioned Laying Technology:

   – Track System: 5×4m sliding tension tracks per side, anchored with 40cm-deep bolts

   – Tensioning:

     – Connect 4 geocell units per Tensioning Unit  using specialized connectors

     – Attach starting end to 34 anchor piles; secure sides to sliding tracks

     – Use a loader to tension geocells to 18–20 kN, ensuring 40cm×40cm mesh integrity

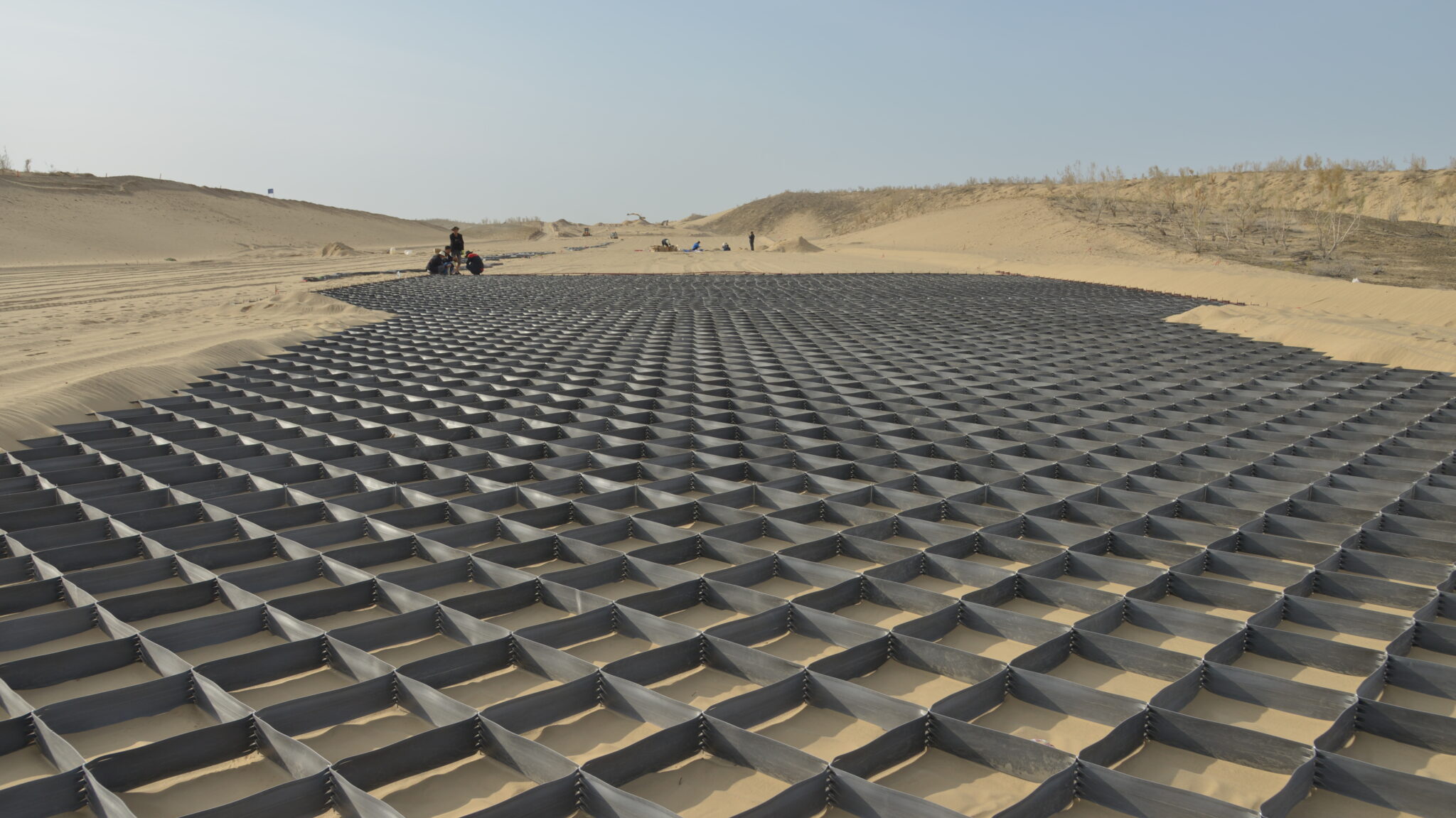

   – Backfilling:

     – Fill with aeolian sand (10cm above geocell height)

     – Compact with rollers after RTK-verified elevation checks

     – Remove anchors and advance tracks for subsequent units

 Key Outcomes

– Feasibility Verified: The 19m ultra-wide pre-tensioned laying process demonstrated:

  – Uniform tensioning (no manual guesswork)

  – 40cm×40cm mesh retention under load

  – Reduced labor (10+ fewer workers vs. traditional manual tensioning)

– Performance Validation: After 96 hours of loader traffic:

  – No voids or dead zones in filled geocells

  – Zero strip/node damage; consistent mesh geometry

– Efficiency Gains: Mechanized tensioning eliminates labor-intensive manual stretching, reduces material waste, and aligns with large-scale construction schedules.
